“We proceeded professionally at the time that we proceeded.”

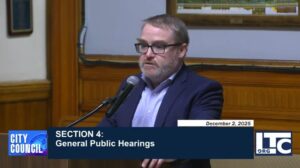

Last night, the City Council met to consider a loan order seeking an additional $40 million for the Lowell High School project. The quote above—“We proceeded professionally at the time we proceeded”—was offered by Jim Dowd, the public face of Skanska, the City’s project manager. He delivered this line while responding to Councilor Belanger, who asked whether Skanska could/should have done more to avoid the massive overrun. In plain language, he was being asked to explain what appears to be a fundamental failure in the project manager’s duty of care.
When cities undertake major public-construction projects—especially complex school renovations—the Massachusetts School Building Authority (MSBA) requires the hiring of a Project Manager (PM). The PM is not ornamental; this requirement exists precisely to protect municipalities and taxpayers from runaway construction costs.
Before any work begins, the PM must conduct a thorough investigation of the building’s structural integrity, utilities, hazardous materials, and architectural conditions. This phase is crucial: it defines the actual scope of work, the realistic timeline, and the budget. A competent evaluation identifies risks so that contingencies are sized appropriately.
When this phase is done well, surprises are minimized. When it is not, the project becomes a financial minefield.
In Lowell’s case, the city’s project manager failed to ensure adequate pre-construction testing, most notably the drilling of bore holes in the basements of the 1892 and 1922 buildings. This omission delayed the discovery of a defective floor—an avoidable finding had the PM performed its basic responsibilities. Because the discovery came so late, the entire project timeline was pushed back by a full school year.
The consequence? We now must pay contractors an additional year’s worth of labor costs.
This was not a case of unforeseeable surprises unique to century-old buildings. Indeed, this seems to be Skanska’s favorite excuse. This excuse is pure bullshit. Renovations always carry unknowns; that’s why a competent PM builds contingencies to absorb them. The problem here was not the age of the buildings (or where they are located) —it was inadequate investigation and a contingency fund too small to account for foreseeable risks.
To make matters worse, while the MSBA was involved from the outset, its funding is not guaranteed. Reimbursement is limited to eligible, pre-approved costs. Any cost above those limits becomes the responsibility of the City. Because Skanska failed to anticipate and identify the true scope of the project, the full $40 million overage now lands squarely on Lowell taxpayers.
Against this backdrop, probing questions from councilors on behalf of taxpayers are entirely appropriate. However, Mr. Dowd appeared visibly annoyed at being questioned about a $40 million overrun—money that, by all accounts, stems from failures in oversight on his firm’s watch.
It was the kind of posture rarely seen in the private sector. Most employees would not survive responding to their employer with indignation or irritation when being asked to explain a multi-million-dollar mistake. Yet the taxpayers—Skanska’s ultimate employer in this scenario—were (and routinely have been) treated to precisely that. (Judge for yourself around the 40-minute mark of the meeting).

[Author note – initially, I thought the loan order passed. This was reflected in an earlier draft of this blog. The source of my confusion is explained in the comments below. However, as you can see, Councilor Jenness pointed out that the loan order failed. I amended this blog to reflect the accurate result of the vote.]
Despite all this, the Council’s options appear somewhat limited. Lowell has a binding agreement with the MSBA to deliver the project as designed. Refusing the additional funding could trigger far worse consequences. Ultimately, a minority of councilors opted to roll the dice. Councilors Gitschier and Descoteaux voted in opposition. Councilors Nuon and Robinson were absent. As a two-thirds majority of the full eleven-member council was required— the seven affirmative votes amounts to a percentage less than the necessary 2/3.

I have no idea where we go from here.
